Structural As-Built Drawing Services Built Around Verifiable Evidence

An as-built drawing should explain what was constructed, not simply remove revision clouds from the last design issue. Reliable record documentation depends on field evidence, authorised changes and a clear distinction between verified conditions and information that remains uncertain.

Our structural as-built drawing services consolidate contractor redlines, surveys, inspection records, approved change documents, fabrication information and existing models into organised record packages. CAD Conversion Services India prepares AutoCAD drawings and Revit models while preserving the source and verification status of significant updates.

AI-assisted comparison may help locate differences across drawing issues, but human reviewers determine which changes are supported by evidence and which require clarification.

✓ AI Powered✓ Free Pilot Batch✓ NDA Protected✓ 99.5% Quality
Construction surveyor using precision levelling equipment to verify field conditions on an active building site
Structural field verification
1500+Completed Projects
82%Returning Clients
10+Years Experience
45+Countries Served
35+Professionals Team

Project Fit at a Glance

Confirm these essentials before production begins.

Inputs

Engineer-issued design information, calculations, mark-ups and project standards

Outputs & deliverables

Structural models, drawings, schedules and material-specific detailing

Software

AutoCAD, Revit and agreed structural-production tools

Service intent

Focused production support for Structural As-Built Drawing Services, with scope, source authority and review responsibility agreed before work begins.

IndustriesArchitectureConstructionManufacturingEngineeringReal EstateCountries ServedUSACanadaUKAustraliaUAEEuropean Nations45+ Countries

“As Built” Is an Information Status, Not a Drawing Style

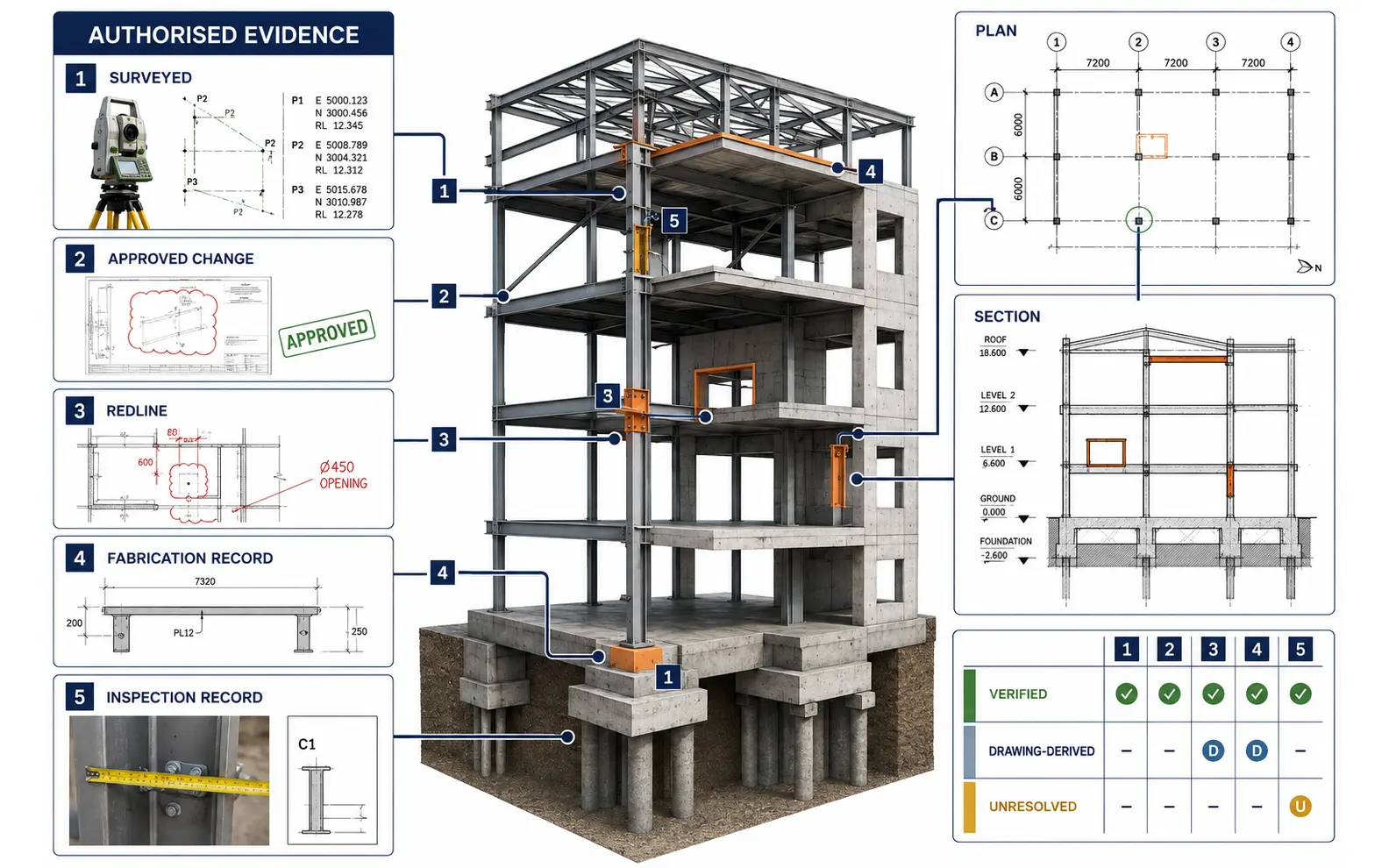

Structural as-built evidence map connecting surveys, approved changes, redlines, fabrication records and inspections to verified, drawing-derived and unresolved record conditions
Every significant record change remains connected to its authorised evidence and is classified honestly as verified, drawing-derived or unresolved.

Structural record drawings can include foundations, framing, concrete, steel, openings and other relevant constructed conditions. Their value depends on the source behind each change.

Before updating files, we establish an evidence hierarchy such as:

  • Signed or authorised field-change documents
  • Surveyed coordinates, dimensions and levels
  • Approved fabrication or shop-drawing information
  • Contractor and subcontractor redline sets
  • Inspection reports and photographic records
  • Requests for information and approved responses
  • Site instructions and change notices
  • Latest design and construction issues
  • Existing CAD, BIM or asset-documentation files

The client identifies which sources are authorised for the final record. This produces a structural as-built drawing solution that is traceable rather than a combination of unranked mark-ups.

Turning Redlines into Controlled Drawing Updates

Redline structural updates can range from a moved opening to extensive changes in member sizes, foundation geometry or framing layouts. We register each mark-up by source, date, drawing reference and approval status before applying it.

The workflow may include:

  • Comparing redlines with the latest issued drawing
  • Separating design changes from site annotations
  • Checking whether one change affects multiple sheets
  • Recording unclear dimensions or conflicting comments
  • Linking approved responses to updated details
  • Maintaining superseded and current issue records
  • Applying agreed record-drawing notes and legends

Field notes are not silently interpreted as engineering instructions. If a redline suggests a structural change without adequate approval or supporting dimensions, it remains a query until the authorised party confirms how it should be documented.

Foundation and Framing Record Plans

Foundation as-built drawings may show verified footing, pile, pile-cap, raft, ground-beam or wall locations, dimensions and levels. The available evidence determines how precisely the constructed condition can be represented.

As-built framing plans can document confirmed member sizes, positions, orientations, openings and level relationships. Separate plans may be required for steel, concrete, timber or mixed systems where their evidence and revision histories differ.

Existing structural condition plans are useful for renovation, maintenance and future design work, but they should not imply that concealed components were surveyed when they were not accessible. Notes, confidence fields or source references can distinguish direct observation from drawing-derived information.

Steel and Concrete As-Built Documentation

Steel structure as-built drawings can incorporate verified fabrication changes, member substitutions, connection revisions and erection adjustments. Shop drawings, fabrication records and site redlines may all contribute, but the client must confirm which sources represent the accepted construction.

Concrete as-built documentation may address dimensions, levels, openings, joints, embeds and approved reinforcement changes where evidence exists. Concealed reinforcement cannot be claimed as field verified merely because it appears in an approved design or shop drawing.

An expert reviewer checks whether the language and drawing status accurately reflect the available evidence. Record documentation is not used to certify workmanship, structural adequacy or compliance unless those responsibilities are separately assigned to qualified professionals.

Field Change Drawings and Downstream Impact

Field change drawings record authorised deviations or site instructions affecting constructed work. A single change can influence plans, sections, details, schedules and model geometry.

Examples include:

  • Revised foundation or anchor locations
  • Member substitutions and framing adjustments
  • Relocated or resized structural openings
  • Approved connection changes
  • Concrete profile or level modifications
  • Additional supports or secondary framing
  • Embedded-item and equipment-base revisions
  • Changes arising from site constraints

We review the document set for related references rather than updating only the sheet carrying the redline. If the evidence does not establish the full downstream effect, the limitation is recorded for client review.

AutoCAD Structural Record Drawings

AutoCAD structural record drawings can be prepared by revising client files or recreating legacy information in an organised CAD structure. Title blocks, layers, lineweights, text styles, symbols and file names follow the approved project standard.

When CAD files are missing, PDFs or scanned drawings may be redrawn before field changes are incorporated. Scale, dimensions and legibility are reviewed first; unclear source geometry is not treated as surveyed fact.

Drawing cleanup is kept separate from factual revision. Standardising layers or annotation does not authorise a change to the recorded structural condition.

Revit Structural As-Built Models

A Revit structural as-built model can consolidate verified geometry, element information, views and schedules for handover or future asset use. The model’s level of information and verification status must be agreed before development.

Possible requirements include:

  • Project coordinates, grids and constructed levels
  • Confirmed structural element locations and sizes
  • Verified openings and major interfaces
  • Element identifiers and required asset parameters
  • Links to record drawings or supporting documents
  • Model views and schedules for handover
  • Classification of surveyed and drawing-derived elements

A professional modeler checks coordinates, categories, families, parameters, warnings and drawing views. The model does not become more authoritative than its evidence merely because it is three-dimensional.

Final Structural Documentation for Handover

Final structural documentation may include drawings, models, schedules, source registers and outstanding-information lists. The agreed handover package should explain its issue status and limitations so future users understand what they can rely on.

Deliverables may include:

  • Structural record plans, sections and details
  • Consolidated redline registers
  • Foundation and framing as-built drawings
  • Steel and concrete record documentation
  • Field-change and RFI reference schedules
  • Revit models and model-status notes
  • DWG, PDF, RVT, IFC and agreed register formats

File names, drawing numbers and revisions are checked across the complete package. Superseded information is archived or identified according to the client’s document-control procedure.

A Record-Production Process That Protects Provenance

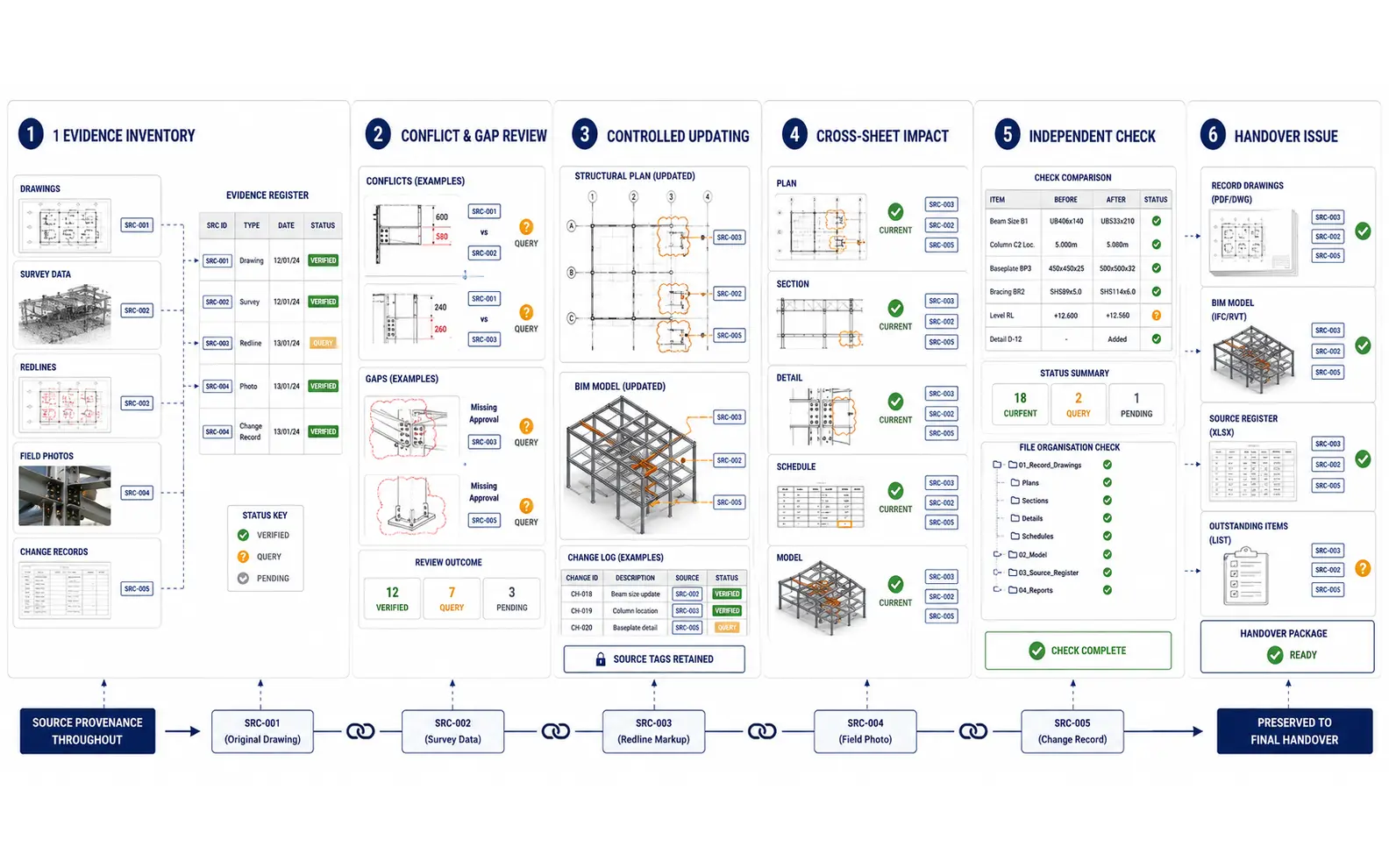

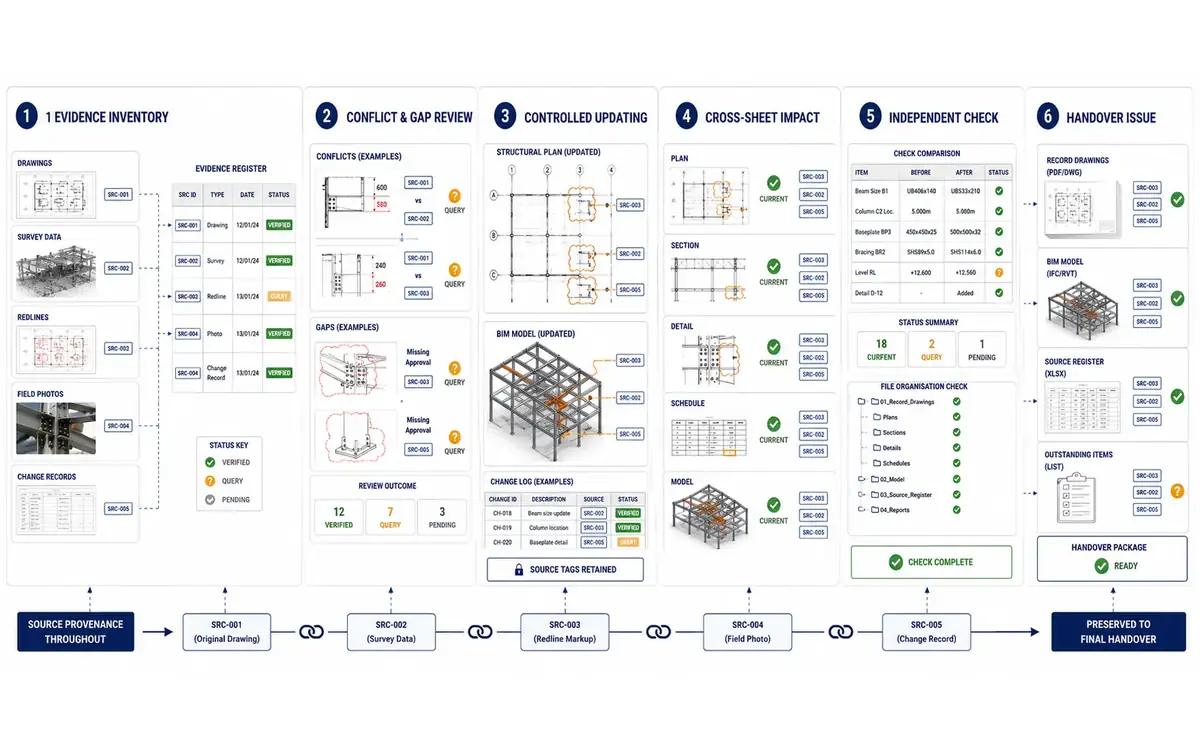

Six-stage structural record workflow from evidence inventory and conflict review through controlled updating, cross-sheet impact, independent checking and handover
Source references remain visible as approved changes move across drawings, model views and schedules into the checked handover package.

Evidence Inventory for Structural As-Built Drawing Services

We register drawings, redlines, surveys, models, inspection records and change documents. The client confirms their authority and priority.

Conflict and Gap Review

Contradictory dimensions, incomplete mark-ups and unsupported field changes are logged before production.

Controlled Updating

Approved changes are applied to drawings and model elements with source references retained in the working register.

Cross-Sheet Impact Review

Plans, sections, details, schedules and model views are checked for every confirmed change.

Independent Checking for Structural As-Built Drawing Services

An expert checker reviews update completeness, source traceability, issue status, notes and file organisation. Automated comparison supplements the review.

Handover Issue

The record package is delivered with agreed status notes, outstanding items and supporting registers. Client corrections are incorporated before final acceptance.

Offshore Capacity for Large Record-Documentation Backlogs

Our external-production structural as-built drawing services can support a completed project, an archive of legacy facilities or a recurring stream of handover packages. Work can be organised by building, floor, asset, discipline or evidence status.

Clients may outsource structural as-built drawing production when internal teams cannot absorb extensive mark-up consolidation. Structural as-built drawing outsourcing services can also provide recurring capacity through outsourced structural as-built drawing support.

As an expert structural as-built drawing service provider, we keep evidence sources and unresolved discrepancies visible. Our professional structural as-built drawing services do not turn uncertain information into verified conditions.

The external-production team follows the client’s security, document-control and approval procedures while keeping each project record separate.

Structural As-Built Drawing Services Project Case Studies

Project 1: Record Drawings for an Expanded Food-Processing Facility

Volume
186 structural drawings across four production buildings
Problem
A United States manufacturer had completed several extensions over eight years. Structural records were dispersed across design issues, contractor redlines, steel fabrication files and equipment-installation projects, making future modification planning difficult.
Solution
We created an evidence register by building and compared every candidate source with the latest base drawings. Confirmed framing, openings and equipment-support changes were incorporated, while unresolved conditions were placed on a verification list. Fabrication information was used only where the client accepted it as the construction record.
Outcome
The facilities team received a consolidated drawing set with clear source notes and remaining verification priorities. Future engineers could distinguish accepted record information from areas requiring site investigation.
Title
Facilities Engineering Manager
Industry
Food Manufacturing
Country
United States

Project 2: Survey-Based Concrete Record Model for a Parking Structure

Volume
11 levels, 1,420 columns and 268 surveyed slab-edge deviations
Problem
A South African asset owner needed an as-built model before façade and repair work. Original concrete drawings existed, but surveys showed recurring slab-edge and ramp differences that could affect access systems and repair quantities.
Solution
We established project coordinates from the approved survey and classified model elements as surveyed, design-derived or unresolved. Slab edges, ramps, columns and major openings were updated where evidence supported them. Concealed reinforcement and unmeasured elements remained explicitly outside the verified model status.
Outcome
The repair team obtained a usable spatial reference for access planning and façade interfaces. The model’s confidence classification prevented unverified geometry from being mistaken for complete survey coverage.
Title
Asset Information Lead
Industry
Commercial Property Management
Country
South Africa

Project 3: Recurring As-Built Packages for Retail Refurbishments

Volume
5–8 store handover packages per month
Problem
A UK retail contractor completed frequent structural alterations involving openings, secondary steel and equipment supports. Handover documentation arrived from different subcontractors in inconsistent formats and often close to completion deadlines.
Solution
We introduced one record checklist, redline register and drawing-status convention across the programme. Each store package was processed separately, with unsupported marks returned to the relevant site manager. A consistent checker reviewed cross-sheet changes before handover.
Outcome
The contractor gained a repeatable closeout workflow without mixing store records. Missing evidence was identified earlier, and completed packages followed a consistent structure for the client’s asset archive.
Title
Programme Handover Manager
Industry
Retail Construction
Country
United Kingdom

Structural As-Built Drawing Services Client Feedback

Questions About Structural As-Built Drawing Services

Can you create as-built drawings without a field survey?

We can prepare record drawings from authorised redlines, fabrication records and change documents, but their status must reflect those sources. Conditions cannot be described as surveyed if no verified field measurement exists.

Do you verify whether the constructed work is structurally adequate?

Not within a standard documentation scope. Structural assessment, compliance review and certification require a separately agreed engineering service performed by qualified professionals with access to the necessary evidence.

Can you combine several redline sets into one record package?

Yes. We first register and compare the sources, resolve their priority with the client and identify contradictions. Unresolved differences remain visible rather than being combined through guesswork.

Can you update both CAD drawings and a Revit model?

Yes, when both deliverables are included and their relationship is defined. We check that confirmed changes appear consistently in the drawings, model views and schedules.

Let the Evidence Define the Record

Send the latest drawings, redlines, surveys, approved changes, fabrication information and required handover format. We will assess source quality and propose a practical professional workflow.

Whether you need to outsource one completed project or add recurring external-production capacity, every recorded change should remain traceable to an authorised source.

Request an As-Built Documentation Review
